All posts

Share

You Don't Need a Better Time Tracker, You Need a PSA

Share

Time tracker vs PSA: a chalk stopwatch on charcoal leads along a path through ring nodes to a yellow star, while two dotted lines end in empty circles

By Lauri Eurén, CEO of Operating. Disclosure: Operating (operating.app) publishes this page and sells a PSA. We say clearly where a time tracker or a resource planner is the better choice. Last updated October 1, 2026.

Short answer: A time tracker records work that already happened. A resource planner plans the work people should do next. A professional services automation (PSA) platform connects both to the sales pipeline, rates, costs, budgets and billing, so one staffing change updates utilization and margin forecasts. If your problem starts after the timesheet is submitted, a better timer will probably not fix it.

One correction for 2026: Harvest, Toggl and Clockify now do much more than record hours. Many firms that think they need PSA actually need better planning. Some need nothing new. This guide helps you tell the cases apart by symptoms, not headcount.

TL;DR

You needWhen
A better time trackerThe pain is time capture, approvals, timer UX or historical reports.
A resource plannerThe pain is future staffing, capacity or forecast utilization, and billing already works.
A PSAPipeline, staffing, delivery actuals and project economics must agree, and people reconcile them by hand every month.
A weak triggerHeadcount. Vendor guides put the line anywhere from about 15 to over 200 people.
A strong triggerCoupling: a won deal changes staffing, staffing changes cost, actuals change margin, contract type changes revenue.

Time Tracking vs Resource Planning vs PSA

The categories overlap. The clearest way to separate them is by the record each one is built on.

Three layers, three records

LayerCore questionBuilt onTime horizon
Time trackerWhat work happened?Time entriesPast and present
Resource plannerWho should work on what, and do we have capacity?Allocations, availability, tentative workPresent and future
PSAWhat does the work mean for delivery and money, from deal to invoice?Projects, people, plans, actuals, rates, costs and contract rules on one modelPast, present and future

SAP describes PSA as covering the service lifecycle "from sales and staffing to billing and reporting" (SAP). A PSA does not need to replace your CRM, task tool or general ledger. What makes it different is that planning, time, rates, costs and billing share one project and resource model.

What Modern Time Trackers Can Actually Do

Many PSA comparisons still describe trackers as timers with reports. That is out of date. Here is what the vendors' own documentation shows as of September 2026.

What trackers do (vendor docs, September 2026)

CapabilityHarvest (+ Forecast)TogglClockify
Timesheet approvalsEnterprise planPremium and EnterpriseStandard and up (docs)
Cost rates and profitCost rates on Teams; profitability report on EnterpriseLabor costs and profitability report on PremiumLabor cost and profit on Pro
UtilizationTracked hours ÷ capacityBillable hours ÷ scheduled work hours on PremiumNo dedicated utilization report
Scheduling and capacityThrough Harvest Forecast, billed separatelyTimeline and workload views in the current Toggl productScheduling and forecasting on Pro
Planned vs actualEstimates vs actuals with Forecast connectedTime actuals vs estimates on Premium dashboardsAssigned vs actual hours on Pro
InvoicingStandard, recurring and retainer invoicesPDF invoices from reportsInvoices on Standard and up
CRM deals as staffing demandNot foundNot foundNot found
Revenue recognition methodsNot foundNot foundNot found

So "trackers cannot plan capacity" and "trackers cannot calculate profit" are false for these products. Two things were missing from the documentation we reviewed: a native path from CRM deals to staffing demand, and revenue recognition methods. That is where the category boundary starts.

If you mostly bill time and materials (T&M), staff from stable teams, and your tracker already shows cost and profit, you may not need anything new.

Actual vs Planned vs Forecast

Most confusion in this category comes from mixing three datasets.

Actual, planned and forecast

ViewQuestionExamplesUsual system
ActualWhat happened?Time entries, billable hours, historical utilization, project cost to dateTracker or PSA
PlannedWhat do we intend to happen?Allocations, availability, time off, capacity, planned utilizationResource planner or PSA
ForecastWhat might happen if pipeline converts?Tentative bookings, pipeline demand, forecast utilization, hiring needs, bench risk, forecast revenue and marginPlanner with tentative work, or PSA connected to CRM

A time report can show that your cloud architects were under-used last month. It cannot tell you that three likely deals will need two more architects in six weeks. That needs future supply (who is free after time off and bookings) and future demand (confirmed plus tentative work).

The chain runs from CRM deal to tentative demand, resource plan, delivery, time, margin and invoice. A tracker enters at delivery. A planner covers demand and the plan. A PSA connects the chain, so a change at one step updates the next.

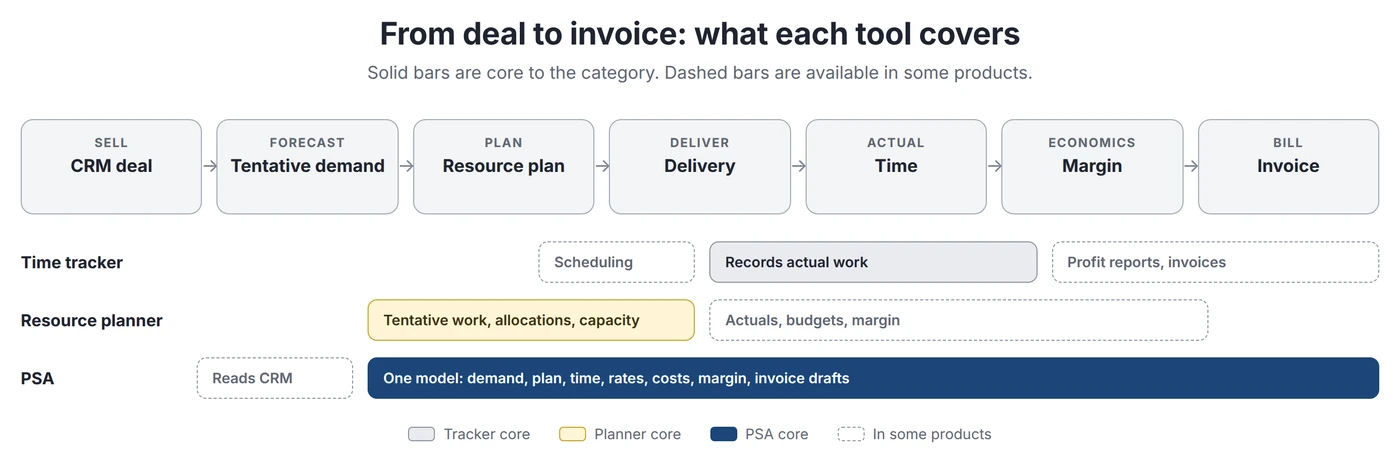

Flow from CRM deal to tentative demand, resource plan, delivery, time, margin and invoice, showing which part a time tracker, a resource planner and a PSA cover
From deal to invoice. A tracker covers delivery and time, a planner covers demand and the plan, and a PSA connects the chain to margin and billing.

Seven Signs You've Outgrown Time Tracking

No single sign proves you need PSA. The signal is several at once, each forcing someone to reconcile data by hand.

1. Staffing lives in spreadsheets

Timesheets are accurate, but allocations live in a sheet. The sheet says 80% on a project. Actuals say 110%. Nobody sees the drift, because plans and actuals are not linked.

Better tracker: partly, as Toggl and Clockify now schedule. Planner: usually the first fix. PSA when allocations must also drive cost, margin forecasts and billing. Exception: a few stable teams on long engagements.

2. Pipeline affects hiring and staffing

When likely deals decide whether you hire, subcontract or keep people free, the plan must hold uncertain work apart from confirmed work. The mechanism: deal, dates, role mix, hours, probability, weekly demand, capacity gap, decision.

Better tracker: rarely. Planner: often. Runn supports tentative projects and scenarios (Runn help). PSA when the deal must become a project with a budget, rates and billing terms. Exception: fast hiring or predictable start dates.

3. Utilization problems are discovered after they happen

Last month's timesheets show a bench problem only after the hours are gone. Forecast utilization, built from allocations and working hours, gives you weeks to react.

Better tracker: some show workload against scheduled hours. Planner: yes. PSA when the forecast must include pipeline and feed revenue and margin. Exception: firms that sell outcomes, not hours.

4. Profitability requires spreadsheet reconciliation

Someone exports hours, adds cost rates from HR and expenses from finance, then matches it to contract value, because rates, costs and terms sit in different systems.

Better tracker: for simple T&M, yes. Planner: Float and Runn link schedules to rates and margin. PSA when fixed-fee, capped and T&M work share one portfolio and you need forecast margin, not just margin to date.

5. Planned versus actual is disconnected

Planned-versus-actual reports alone are not a PSA feature. Toggl, Harvest with Forecast, and Runn offer them. The PSA signal is what the variance should change. If a project burns 20% more hours than planned, that should update capacity, the completion forecast, cost, forecast margin and the billing outlook. If a person carries that by hand into four places, your systems are not connected.

6. Multiple billing models create operational complexity

In T&M, an hour creates revenue. In capped T&M, it does until the cap. In fixed price, it creates cost but no extra revenue. Milestones, retainers and recurring fees move invoice timing away from earned revenue. Under IFRS 15, revenue is recognised as performance obligations are satisfied (IFRS Foundation).

Trackers handle fixed fees and recurring invoices. The issue is a mixed portfolio that needs one view of earned revenue, invoiced revenue and margin.

7. Finance rebuilds operational data every month

Export timesheets, chase missing time, join project data, fix rates, map contract types, add expenses, find unbilled work, work out earned amounts, draft invoices, post to accounting, rebuild reports. Thomson Reuters defines work in process (WIP) as "billable time and expenses that haven't yet been billed" (Thomson Reuters).

This is the strongest single sign when it exists because systems do not share IDs, rates, contract rules and approval status. A tracker or planner rarely fixes it. Exception: a short, controlled export routine is not worth a new system.

Better Tracker, Resource Planner or PSA?

Diagnostic: which category fixes it?

SymptomLikely causeBetter trackerResource plannerPSA
Poor timesheet complianceFriction, no reminders or approvalsYesNoOverkill
Bad timer UXCapture interfaceYesNoNo
Weak historical reportsReporting gapsUsuallyNoSometimes
Manual staffingNo allocation modelPartlyYesIf staffing must drive cost and billing
Unclear future capacityNo supply and demand viewBasic viewsYesYes
Pipeline-driven hiringSales demand not in the planRarelyOftenYes, when deals must become budgets
Forecast utilizationNo future demand modelSomeYesYes, when it must include pipeline and margin
Planned-vs-actual gapsPlan and actuals kept apartSomeYesYes, when the gap must move the margin forecast
Margin discovered too lateCost, revenue and plan kept apartPartlyPartlyStrong signal
Multiple billing modelsContract rules differ by projectPartlyRarelyStrong signal
Monthly data reconciliationNo shared model across teamsNoNoStrong signal

A simple rule: if the problem happens before or while someone submits a timesheet, test a better tracker. If it happens when you decide who does future work, test a resource planner. If sales, staffing, delivery and finance each hold a different version of the same project, test a PSA.

Why Project Economics Change the Equation

These are industry conventions. Firms define them differently, so write your definitions down before comparing tools.

Key terms and formulas

TermMeaningFormula or note
Billable utilizationShare of available time spent on billable workBillable hours ÷ available hours × 100 (Kantata). Denominators vary; Operating makes both parts configurable.
Forecast utilizationThe same ratio for a future periodForecast billable allocations ÷ forecast available hours × 100
RealizationHow much of standard value is billedBilled amount ÷ standard value (Practice CS)
BenchAvailable people not on client workAvailable hours − committed client hours − other planned work
Cost rateInternal cost of one hourSalary, loaded or standard cost by role
Rate cardWhat you charge per hourBy role, seniority, client or date
Project marginProfit as a share of revenue(Revenue − labor cost − external costs − expenses) ÷ revenue × 100
Unbilled work (WIP)Billable time and expenses not yet billedGrows when approvals or invoicing lag
Invoicing lagDelay between billable and invoicedInvoice date − period end or milestone approval
Forecast revenueExpected revenue at completionActual revenue to date + planned revenue after the cutoff
Forecast marginExpected margin at completion(Forecast revenue − forecast cost) ÷ forecast revenue × 100

Why hours × rate is not profitability

Hours × billing rate is what the hours would be worth at list price. It leaves out labor cost, external costs, discounts, write-offs and non-billable delivery time. For fixed-fee work it is not even the revenue.

Illustrative example: a $60,000 fixed-fee project is planned at 400 hours at a $90 average cost rate. Planned cost is $36,000 and planned margin 40%. The team logs 520 hours. Cost rises to $46,800 and margin falls to 22%. Revenue stays at $60,000. At a $150 rate card, 520 hours "look" like $78,000, which says nothing about the result. On fixed-price work, earned revenue also follows a recognition method such as cost-to-cost, while invoices follow a billing schedule.

When a Time Tracker Is Enough

Keep your tracker, or upgrade within the category, when most of these are true:

  • One person can see who is free without a planning system.
  • Projects are similar and teams are stable.
  • Pipeline rarely changes hiring or start dates.
  • Billing is mostly T&M or simple fixed fee.
  • Your tracker's cost and profit reports answer your margin questions.
  • Month-end reconciliation is short and controlled.

When a resource planner is enough

Add a planner, and keep your tracker and accounting, when the pain is future staffing and billing already works. Runn offers tentative projects, scenarios and financial forecasts (Runn). Float links schedules to budgets, rates and margin, and says its profitability tools do not replace accounting systems (Float help).

Why headcount is a weak trigger

Vendors disagree. Birdview says firms under about 15 to 20 billable employees with simple T&M can often stay on a tracker (Birdview). BigTime writes about firms "scaling past 30-50 employees" (BigTime). Toggl says the tracker case is strong below 100 people and PSA is likely above 200 (Toggl).

A 60-person firm with stable teams can be simpler than a 20-person consultancy sharing specialists across ten projects. Count concurrent staffing decisions, shared specialists, pipeline volatility, billing models and manual month-end steps. See is a PSA worth it for a 30-person firm.

What Moving to PSA Changes

From a fragmented stack to an operational layer

Before: CRM, a staffing sheet, a tracker, a task tool, accounting, and manual reports joining them. The problem is not the number of tools. It is that the same project, person and rate live in several places with no clear owner.

After: CRM to PSA to accounting. Task tools can stay, connected at the level of positions and allocations rather than tasks (PSA vs project management software).

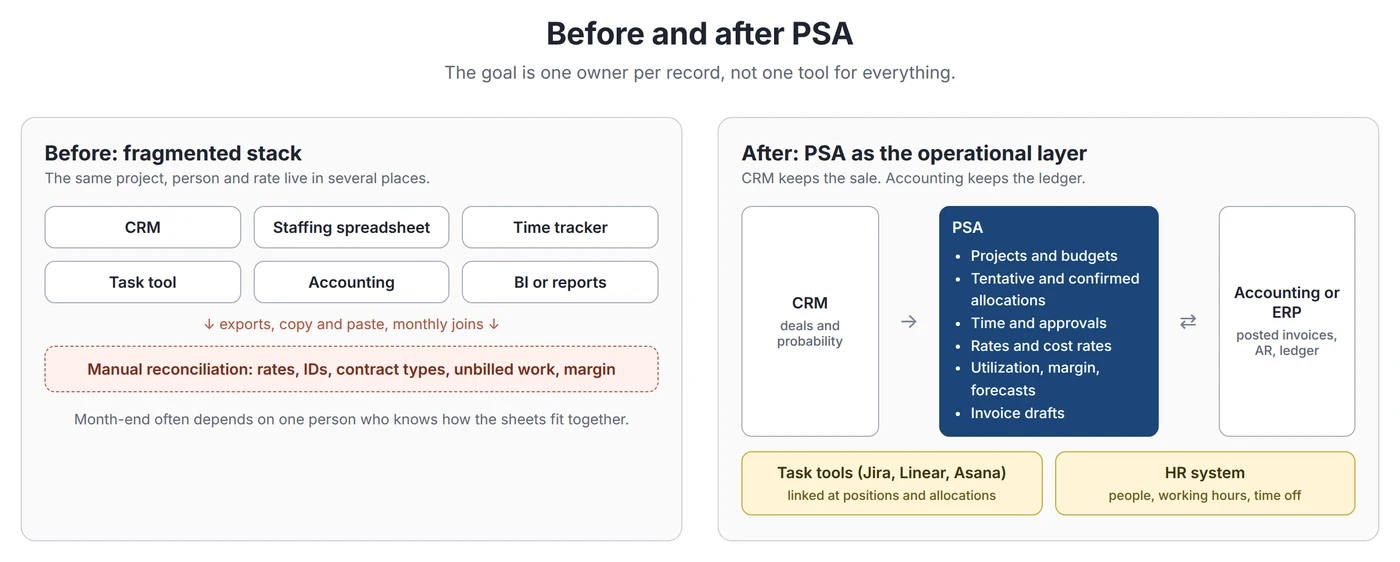

Before and after architecture: before, a CRM, staffing spreadsheet, time tracker, task tool and accounting joined by manual reports; after, CRM feeds a PSA layer that feeds accounting, with task tools and HR connected alongside
Before and after. The PSA becomes the operational layer between CRM and accounting. Task tools and the HR system can stay.

Who owns which record

Likely system of record

RecordUsual ownerNote
OpportunitiesCRMStage, value and probability
CustomersCRM or accountingAgree on one owner for names and IDs
ProjectsPSAOften created from a tentative or won deal
ResourcesHR system, synced to PSAPSA owns availability and skills for staffing
AllocationsPSA or plannerConfirmed and tentative
TimePSA or trackerOnly one should be authoritative
Rates and cost ratesPSA, set by finance policyRestrict who sees costs
InvoicesDrafted in PSA, posted in accountingAccounting holds the legal record
Accounting transactionsAccounting or ERPPSA does not replace the ledger

Aim for one authoritative owner per record, with controlled handoffs. That beats "one system for everything".

A transparent cost case

Skip generic ROI percentages. Put your own numbers in separate buckets. This example is illustrative, not a benchmark.

Illustrative example: 60-person consultancy, monthly

LineAssumptionMonthly effect
Ops reconciliation removed15 of 25 hours × $70 loaded cost+$1,050
Finance reconciliation removed8 of 16 hours × $80+$640
Unbilled work recoveredHalf of $1,500 a month found in your own write-off records+$750
Hard benefits+$2,440
Licenses60 people × $21 (Operating Full Suite, annual billing, as of September 2026)−$1,260
Internal implementation time120 hours × $70, spread over 24 months−$350
Ongoing admin8 hours × $70−$560
Costs−$2,170
Contingent: bench sold60 hours × $90 contribution, only if demand existsUp to +$5,400
Cash timing: invoices 5 days earlier$3M annual billings, 8% cost of capitalAbout +$270, not revenue

Here, hard benefits only just cover the cost. The case depends on whether freed capacity can be sold. That is the honest shape of most PSA decisions, and only your own data shows whether the value is real. Add migration, training and change-management time before you decide.

What to migrate

Migrate what the new process calculates from: active customers, projects, people, rates, cost rates, budgets, open allocations, active work, and enough time history for open projects and unbilled work. Keep older history read-only in the old tool unless audits need it.

Operating's migration guide recommends a parallel pilot group and retiring the old tool at a month end so invoicing runs there one last time (Operating help). Common mistakes: duplicates from unstable IDs, carrying old rates and task lists across, importing time before project and rate mappings are right, and involving finance late. See our PSA implementation rollout plan.

Where Operating fits

Operating (operating.app) is a PSA layer between CRM and accounting. As of September 2026, its documentation shows:

  • HubSpot deals, Salesforce opportunities and Pipedrive deals create tentative projects, one way. Capacity and portfolio reports can weigh tentative work by probability (help).
  • Resource planning, skills, time off, configurable utilization and a utilization forecast.
  • Timesheets and approvals on Plan & Track and above. Four billing types, rate cards, cost rates, margin and three fixed-price revenue recognition methods.
  • Invoicing on Full Suite with Xero and QuickBooks Online sync. NetSuite through the REST API. Native Harvest sync.
  • REST API and a read and write MCP server. No native Jira or Linear connector.
  • $13, $17 or $21 per person per month billed annually ($15, $19, $23 monthly). Enterprise from 100 people, with SLA, custom contract and on-site onboarding (pricing).
  • SOC 2 Type 2, GDPR, AWS hosting in Frankfurt and SSO on every plan (security).

Check fit if you run retainers: there is no dedicated retainer billing type yet, so teams use fixed-price budgets back to back (billing types).

Where the PSA Argument Breaks Down

Advanced trackers already cover a lot

Harvest with Forecast, Toggl and Clockify Pro cover scheduling, estimates versus actuals, cost and profit. A firm on them may not have outgrown anything.

A planner may solve the real problem

If time and accounting work but staffing does not, a planner is a smaller change. Float publishes a story in which Metalab moved from Certinia, a PSA, to Float (Float). It is a vendor claim, but the pattern is real.

Consolidation moves complexity

Someone still owns billing rules, utilization formulas, permissions, rates and integrations inside the PSA. Unusual contracts may not fit its model. Best-of-breed tools can be better in their domain. The case for PSA is fewer uncontrolled handoffs, not fewer logos.

Forecasts depend on inputs

No PSA fixes stale allocations, invented close dates or wrong cost rates. Integration removes mechanical errors, not forecasting errors.

Change can cost more than fragmentation

If your stack needs little reconciliation, a rollout may cost more than it saves. Poor timer UX or one capacity sheet is a reason to fix one layer, not rebuild the stack.

PSA is justified when interdependent problems need one model. It is not a stage every growing firm must reach. If the seven signs describe your month, compare the best PSA tools or book an intro with Lauri.

FAQ

What is the difference between time tracking software and PSA?

Time tracking software records and reports on work already done, and modern trackers add budgets, scheduling and profit reports. PSA connects sales demand, resource plans, time, rates, costs and billing on one project model, so plans and actuals update project economics together.

Is PSA the same as time tracking?

No. Time tracking is usually one part of a PSA, which also covers resource planning, project financials and billing.

Does PSA include time tracking?

Usually, but check the plan. Operating includes timesheets on Plan & Track and Full Suite, not on Planning.

When should a consulting firm move to PSA?

When pipeline, staffing, actuals, project economics and billing are reconciled by hand every month and that work keeps growing. Not at a set employee count.

How many employees should a company have before using PSA?

There is no evidence-based threshold. Vendor guides range from about 15 to over 200 people. Operational complexity is a better predictor.

Can time trackers calculate utilization?

Yes. Toggl divides billable hours by scheduled work hours on Premium. Harvest divides tracked hours by capacity. Check the formula before comparing numbers.

Can time trackers manage capacity?

Some can. Harvest Forecast, Toggl and Clockify Pro offer scheduling and capacity views. The usual gap is pipeline demand and financial forecasting.

What is forecast utilization?

The share of future available hours expected to go to billable work. State whether it counts only confirmed allocations, tentative work or probability-weighted pipeline.

Can PSA replace Harvest?

Often, if its time tracking and invoicing suit your team. You can also keep Harvest and connect it. Operating has a native Harvest sync.

Can PSA replace project management software?

Sometimes, for simple coordination. Engineering and creative teams often keep Jira, Linear or Asana while the PSA owns staffing and project economics.

Is PSA worth the cost?

Only if removed reconciliation, recovered unbilled work and better staffing decisions exceed licenses, implementation, migration, training and admin. Model your own numbers.

What should be migrated from a time tracker to PSA?

Active customers, projects, people, rates, cost rates, budgets, open allocations and enough recent time for open projects and unbilled work.

What should stay outside PSA?

Usually CRM pipeline history, detailed task management, HR master records and the general ledger.

What are signs a firm has outgrown time tracking?

Spreadsheet staffing, pipeline-driven hiring, late utilization surprises, profitability rebuilt in sheets, disconnected planned versus actual, mixed billing models and monthly finance rebuilds.

What is the difference between capacity and utilization?

Capacity is how much working time is available or booked. Utilization is the share of working time spent on a chosen type of work.

Methodology

We built this guide from vendor documentation, accounting sources and current search results. Research closed on September 30, 2026.

  • Time trackers: Harvest, Toggl and Clockify were checked against their pricing pages and help centers, not tested hands-on. "Not found" means we did not find it in their documentation.
  • Resource planners: Runn and Float help centers and product pages.
  • Economics: IFRS 15, Thomson Reuters Practice CS and Kantata. This page is not accounting advice.
  • Operating: operating.app product, pricing, security and integration pages and the help center, as of September 2026.
  • Examples: the fixed-fee project and the cost case are illustrations, not benchmarks.
  • Disclosure: Operating publishes this page and sells a PSA.

Sources

Category and standards

Time trackers

Resource planners

Vendor thresholds referenced

Operating sources

Share

Lauri Eurén is the CEO & Founder of Operating - a former consulting professional with experience from hands-on consulting as well as leading an agency operation.
